Odoo implementation time in 2026 depends on scope, process complexity, data migration, integrations, custom development, and how ready your organization is to make decisions and adopt new workflows. A simple rollout can take a few weeks. A multi-department, multi-warehouse, or manufacturing implementation often takes several months.
The most reliable way to estimate your timeline is to plan by phase with clear deliverables and exit criteria: planning, design and configuration, data migration, testing and training, then go-live and stabilization.
This guide explains how long each phase typically takes, what factors extend timelines, and how to build a schedule you can actually execute without sacrificing data integrity, user adoption, or operational stability.
TL;DR
- Fastest timelines happen when the scope is small, data is clean, integrations are minimal, and ownership is clear.
- Most delays come from unclear requirements, late scope changes, messy data, integration issues, and underprepared users.
- A practical timeline includes two migration test waves, end-to-end testing, UAT signoff, role-based training, and a defined stabilization window.
- Phased delivery often reduces risk and speeds up time to value compared to a high-risk big-bang rollout.
What “Odoo Implementation Time” Actually Includes
When people ask “How long does Odoo implementation take?”, they often mean “How soon can we use Odoo?” Implementation time includes the work required to make Odoo operationally dependable:
- Requirements and workflow mapping
- Module selection and configuration
- Security roles and approvals
- Integration design and build
- Data migration, validation, and reconciliation
- Testing: unit, integration, process, regression
- User acceptance testing (UAT) and signoff
- Training by role and workflow
- Cutover planning, go-live execution, and rollback readiness
- Post go-live stabilization and support
A timeline estimate that ignores migration validation, UAT, and training is not a timeline. It is a guess.
Key Odoo Implementation Timeline Factors
1) Scope and number of workflows
The number of workflows you implement matters more than the number of modules on paper. A “Sales + Accounting” rollout can be simple or complex depending on approvals, pricing rules, reporting needs, and compliance constraints.
Timeline expands when:
- Multiple departments go live together
- There are many approval stages
- Reporting requires complex KPI alignment
- Multi-company consolidation is required
- Multi-warehouse routing is required
- Manufacturing routings and quality are included
2) Data migration scope and data quality
Migration delays are common because teams underestimate the time required to remove duplicates, fill missing fields, standardize units of measure, and reconcile financial totals.
Timeline expands when:
- Data is spread across multiple systems
- Historical data scope is large
- Finance requires audit-grade reconciliation
- Product catalogs include variants, attributes, and inconsistent naming
- Inventory requires lot or serial tracking
3) Integration landscape
Integrations extend timelines because they introduce mapping, testing, monitoring, and failure handling work. The more systems you connect, the more edge cases you need to validate.
Timeline expands when:
- Multiple external systems must connect at go-live
- Integrations require near-real-time sync
- Reconciliation is needed when systems disagree
- Monitoring and alerts must be production-ready
- Sandbox or test environments are limited
4) Custom development depth
Custom development adds build time and multiplies testing time. A small report might be quick. A custom module that touches inventory, accounting, and approvals increases complexity, QA load, and regression risk.
Timeline expands when:
- Custom modules alter core flows
- Custom code lacks clear acceptance criteria
- Customizations are discovered late during UAT
- Change control is weak or inconsistent
5) Organizational readiness and decision speed
Even with strong technical execution, timelines slip when decisions are slow. Requirements workshops, signoffs, and UAT need real availability from process owners and key users.
Timeline expands when:
- Stakeholders are unavailable for workshops
- Process owners cannot sign off requirements
- Business rules differ across teams
- Users are not available for UAT
- Training is treated as optional
Typical Odoo Implementation Timelines
| Rollout type | Common scope | Typical timeline |
| Small (5 to 25 users) | CRM, Sales, Invoicing; light migration; few integrations | 4 to 8 weeks |
| Mid-sized (25 to 75 users) | Sales, Purchase, Inventory, Accounting, shipping, or payments, open orders and balances migrated | 8 to 16 weeks |
| Large (75+ users, multi-company, or manufacturing) | Multi-warehouse, manufacturing, traceability; multiple systems; heavier migration and testing | 4 to 9 months |

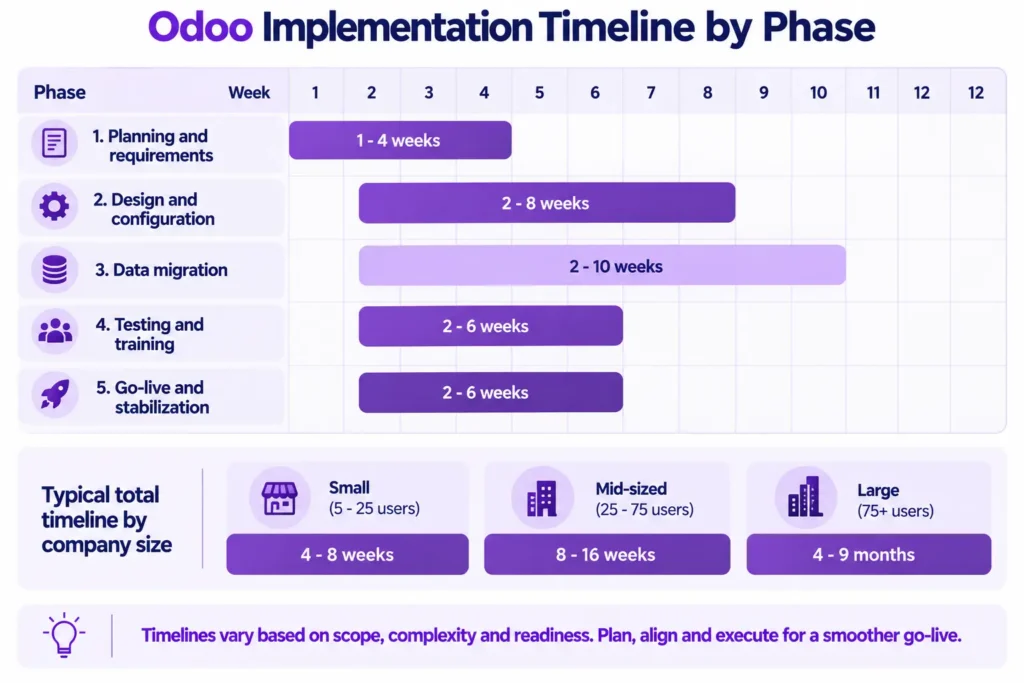

Phase-by-Phase Timeline Breakdown
A timeline built on phases is predictable because each phase has deliverables and signoffs.
Phase 1: Planning and Requirements (typically 1 to 4 weeks)
Objective: lock scope, owners, and acceptance criteria before configuration.
Key activities
- define goals and KPIs (order-to-cash, inventory variance, close cycle time)
- identify process owners and decision makers
- inventory current systems, integrations, and reports
- map current workflows and define future workflows
- define scope boundaries, phases, and change control
- define migration scope and validation thresholds
- define integration scope and source-of-truth rules
What extends Phase 1
- unclear process ownership
- conflicting rules across departments
- no agreement on reporting and KPIs
- attempts to include too many workflows in phase 1
Exit criteria
- approved scope and phased plan
- signed-off workflows and priorities
- change control process agreed
- migration and integration scope baseline created
Phase 2: Design and Configuration (typically 2 to 8 weeks)
Objective: configure Odoo to match workflows, with secure roles and governance.
Key activities
- module selection and configuration blueprint
- role and permission matrix, segregation of duties
- master data governance rules (who can create products, customers, vendors)
- approval workflows and automation rules
- configuration log and decision record creation
- initial reporting and dashboard alignment to KPIs
- integration design finalized
What extends Phase 2
- frequent changes to scope during configuration
- unclear naming standards and master data structure
- late security model decisions
- stakeholders wanting customization before process clarity
Exit criteria
- core workflows configured in staging
- permissions validated for key roles
- configuration standards applied consistently
- integration design approved for build
Phase 3: Data Migration (typically 2 to 10 weeks, overlaps other phases)
Objective: migrate accurate, usable data with validation and reconciliation.
Key activities
- data profiling, cleansing plan, ownership assignments
- mapping workbook and transformation rules
- test migration wave 1, validation, corrections
- test migration wave 2, validation, reconciliation
- final migration runbook for go-live
What extends Phase 3
- heavy duplication and missing values
- inconsistent product catalog structures
- large historical data scope
- finance reconciliation failures requiring rework
- unclear ownership of data corrections
Exit criteria
- migration test waves completed
- reconciliation thresholds met
- signoff from operations and finance process owners
- final migration scope frozen
Phase 4: Testing and Training (typically 2 to 6 weeks)
Objective: prove operational readiness and prepare users for day one.
Key activities
- unit testing for configuration and permissions
- integration testing with failure-path scenarios
- end-to-end process testing including exceptions
- regression testing after changes
- UAT scripts, UAT execution, defect triage
- role-based training with hands-on workflows
- SOPs and exception runbooks creation
What extends Phase 4
- testing only happy paths, then discovering failures late
- too many changes during UAT
- missing test data or unrealistic test data
- users unavailable for UAT
- training scheduled too early or too late
Exit criteria
- UAT signoff based on acceptance criteria
- critical defects resolved or mitigated
- training completed by role
- operational runbooks ready
Phase 5: Go-Live and Stabilization (typically 2 to 6 weeks)
Objective: execute cutover safely, stabilize quickly, and protect operations.
Key activities
- go-live readiness review
- final data migration and reconciliation
- integration switch-over and monitoring
- cutover checkpoints and rollback triggers
- support: triage, fixes, coaching
- performance baselining and optimization
What extends Phase 5
- integration errors without monitoring and reconciliation
- incomplete training causing user bottlenecks
- performance issues from untested report loads
- poor master data discipline creating transaction errors
Exit criteria
- stable order processing, purchasing, inventory, and finance workflows
- issue volume trending down
- performance baselines met
- support model transitioned from steady-state

Timeline Models That Work in Practice
Explore Related Articles
| Timeline model | Best for | How it works |
| Model A | Multi-site teams, early wins, uncertain data | Launch core workflows for one site or team, stabilize and refine migration and training, then roll out to the next group |
| Model B | Manufacturing, multi-warehouse, heavy integrations, finance-led reconciliation | Deliver by dependency: Phase 1 finance and sales, Phase 2 inventory and purchasing, Phase 3 manufacturing and quality, Phase 4 automation and reporting |
| Model C | Strong ownership, clean data, few integrations, standardized processes | Enforce a change freeze before UAT, train users by role, and staff a dedicated go-live and stabilization window |
The Most Common Reasons Odoo Implementations Run Late
Requirements drift and scope creep
When scope changes every week, every phase resets: configuration, testing, training, and migration rules.
Controls that prevent delays:
- enforce change control
- phase enhancements after go-live stabilization
- lock acceptance criteria
Data surprises
Data migration becomes the timeline bottleneck when cleansing is delayed or ownership is unclear.
Controls that prevent delays:
- Profile data early
- Run migration test wave 1 as soon as the basic configuration exists
- Freeze transformation rules
Integration failures were found too late
Many timelines collapse because integrations are built without failure-path testing.
Controls that prevent delays:
- design error handling, retries, and monitoring from day one
- test integration failure scenarios in staging
- build reconciliation workflows
UAT without discipline
UAT fails when users test randomly or when defects are not prioritized.
Controls that prevent delays:
- use scenario-based scripts (capitalize the first letter, maximum content got the issue during pasting it to the google doc)
- include exceptions and approvals
- require sign-offs by process owners
Training is treated as optional
Training is a timeline component because without trained users, go-live becomes a prolonged stabilization period.
Controls that prevent delays:
- role-based training with hands-on workflows
- quick-reference materials and exception runbooks
- scheduled office hours during
Looking for Odoo Implementation, Customization, Integration, or Support Services?
How to Shorten Odoo Implementation Time Without Increasing Risk
You can move faster without cutting corners by tightening scope, starting data and integration work earlier, and enforcing discipline around testing and go-live.
- Reduce phase 1 scope, not phase 1 clarity
Focus on the workflows that move money and inventory first. Defer advanced dashboards, automations, and edge-case customizations, and standardize processes where possible. - Start data work immediately
Profile and cleanse early, create the mapping workbook up front, and run migration test waves as soon as basic configuration exists. - Build integrations with observability from day one
Monitor queues and failure rates, include reconciliation steps, and test failure paths in staging, not after go-live. - Freeze changes before UAT
Set a change-freeze window before UAT starts, allow only critical fixes during UAT, and regression test after each fix batch. - Use a stabilization plan
Define triage rules and escalation paths, run daily incident reviews, and deliver targeted coaching based on real user issues.
Before configuration starts
- scope, priorities, and acceptance criteria approved
- process owners assigned and available
- data sources identified and migration scope defined
- integration list and source-of-truth rules defined
Before UAT starts
- core workflows configured in staging
- test data loaded with realistic records
- integrations working in staging with monitoring
- UAT scripts prepared by role
- training materials drafted
Before go-live
- UAT signoffs complete
- migration runbook and reconciliation checkpoints approved
- cutover plan and rollback triggers ready
- schedule and support coverage defined
- performance baselines validated for key workflows
Conclusion
Odoo implementation time in 2026 is determined by scope discipline, data readiness, integration complexity, customization depth, and the availability of process owners for decisions, UAT, and training. A reliable timeline is built by phases with clear deliverables and exit criteria: planning, design and configuration, data migration, testing and training, and go-live stabilization. When these phases are executed with governance, validation, and role-based adoption, Odoo goes live on schedule and stays stable after launch.
FAQs: How Long Does Odoo Implementation Take?
Can Odoo be implemented in 30 days?
Yes, for a small rollout with clean data, few integrations, and quick decisions. Skipping testing, validation, or training usually turns into longer stabilization after launch.
What usually takes the most time?
Data cleanup, integrations, UAT cycles, and slow signoffs.
Does Odoo Online implement faster than Odoo.sh?
Often yes for standard needs. Odoo Online is simpler to deploy. Odoo.sh fits projects that need stronger development workflows and environment control.
How long does data migration take?
It depends on data quality and reconciliation needs. Plan for two test migrations plus a final cutover run.
How long does an Odoo manufacturing implementation take?
Usually longer because of routings, traceability, quality, valuation, and training. A phased rollout often gets results sooner than launching everything at once.
